Vogtle Hit $15 a Watt as China Halved Nuclear Building Costs

|Updated: |Author: QUASA Editorial Team|5 min read| 1312
Vogtle Hit $15 a Watt as China Halved Nuclear Building Costs

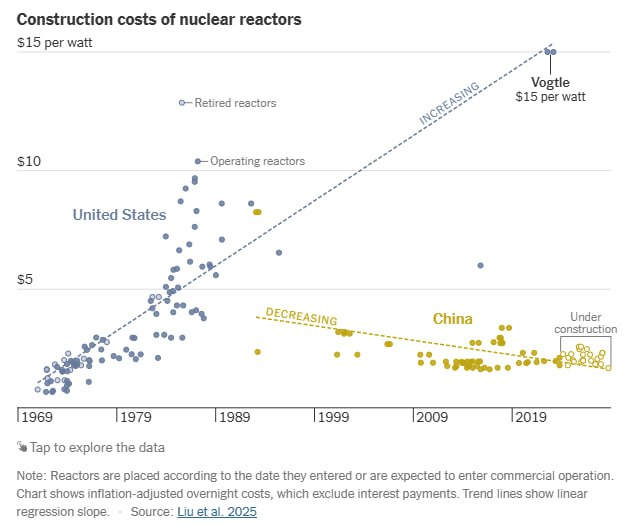

A 2025 Nature cost analysis put Vogtle Units 3 and 4 at $15 per watt in inflation-adjusted overnight construction cost and found that China had halved, then stabilized, its nuclear building costs over roughly two decades. That contrast still holds, but it describes construction performance—not the complete financed cost of a plant or the price of its electricity.

The most important change since that analysis is the widening deployment gap. As of May 2026, China had 60 operating reactors with 58.7 gigawatts of capacity and 36 more under construction across 19 sites, accounting for more than 49% of reactors being built worldwide, according to the latest US Energy Information Administration fleet data.

What the cost comparison actually measures

Overnight construction cost estimates what a plant’s capital works would cost if they could be completed immediately. It covers items such as equipment, engineering and site construction while excluding the interest that accumulates as money remains committed during a multiyear build.

That distinction matters more for nuclear power than for projects with shorter construction schedules. A reactor requires substantial capital before it can sell electricity, so delays increase both the direct expense of keeping a project active and the period over which financing charges accrue.

The metric also excludes fuel, routine operations, maintenance, waste management, decommissioning and costs imposed on the wider electricity system. It is therefore useful for comparing how effectively countries build reactors, but it cannot establish the eventual cost of electricity on its own.

Cross-country comparisons require another qualification. Currency conversion, inflation adjustments, labor markets, financing systems and the treatment of unfinished projects can all affect the result. Estimates for reactors still being built remain provisional, whereas Vogtle provides a completed US benchmark.

Vogtle combined a new design with a broken project sequence

Vogtle’s expansion delivered two large AP1000 reactors and restored recent US experience with completing new commercial units. It also exposed the cost of trying to rebuild engineering, supplier and construction capability within a single project after a long interruption in large-reactor orders.

The Associated Press completion account records Unit 3 entering service in 2023 and Unit 4 in April 2024, with the owners’ projected cost at $31 billion; including a $3.7 billion payment from former contractor Westinghouse brought the wider total close to $35 billion, compared with an initial $14 billion projection and a planned 2017 completion.

Those project totals should not be substituted directly for the overnight-cost estimate. They include a different set of expenses and reflect the project’s financing and contractual history. Both measures nevertheless show the same underlying problem: prolonged construction keeps workers, management systems and borrowed capital committed for longer.

Completing the AP1000 design does not automatically create a low-cost production line. Cost reductions associated with learning depend on another substantially similar project starting while qualified suppliers, experienced crews and established procedures are still available. Without continuity, part of that knowledge must be rebuilt again.

China turned reactor construction into a continuing program

China’s cost trajectory is tied to repetition across a sustained pipeline rather than to one unusually cheap plant. Developers build multiple units under recurring project-management arrangements, giving engineering teams, regulators, manufacturers and construction contractors repeated exposure to related designs.

Standardization does not mean that every Chinese reactor is identical. The fleet includes several technology families, but projects can still reuse major components, procurement channels, licensing work and site practices. The relevant advantage is limiting unnecessary change between successive builds, not enforcing a single blueprint across the country.

Domestic manufacturing developed alongside this construction sequence. Imported technology and equipment played an important role in earlier projects, while Chinese suppliers progressively took on more of the component chain. Higher domestic content was associated with lower unit costs in the analysis, although that relationship does not prove that localization alone produced the decline.

Financing and industrial planning reinforce the physical construction process. Greater confidence that approved projects will proceed helps suppliers invest in equipment and staff, while a deeper supplier base reduces the risk of shortages or one-off manufacturing. Shorter and more predictable schedules then limit interest accumulation, supporting the next round of investment.

The current pipeline shows why this remains more than a historical comparison. A large group of projects at different stages allows crews and manufacturers to move between sites instead of waiting for an isolated national order. It also creates more opportunities to identify construction problems and apply the correction to subsequent units.

The transferable lesson is continuity, not deregulation

The comparison does not show that safety oversight must be weakened to reduce costs. Stable requirements can support efficient construction because designers and contractors know what evidence, equipment and procedures will be required. Late changes are expensive, but predictable review and standardized documentation can reduce that risk without removing scrutiny.

Nor does the evidence establish that a particular advanced or modular design will be cheap from its first deployment. A new reactor still carries design-completion, licensing, factory setup and workforce-training costs. The economic case for modular production depends on enough substantially similar orders reaching construction to spread those expenses and preserve learning.

For the United States, the central challenge is therefore institutional as much as technical. A lower-cost program would need a credible sequence of projects, limited redesign, dependable suppliers, realistic schedules and teams able to transfer directly from one site to the next.

Vogtle demonstrates that the United States can finish a modern large reactor, but at a construction cost that is difficult to repeat commercially. China’s experience shows the opposite trajectory is possible when reactor building becomes a durable industrial program; it does not prove that another country can obtain the same result without recreating the conditions that made repetition possible.
