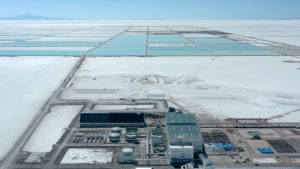

Rhyolite Ridge Is Approved—but Its Lithium Still Depends on Financing

Rhyolite Ridge remains federally approved, but it is not an operating lithium mine. Its latest public milestone is a pair of non-binding agreements with potential Korean partners, leaving financing and a final investment decision between the Nevada project and full construction.
The approval itself is historical, not new: the Bureau of Land Management’s decision notice identifies October 24, 2024, as the date the Interior Department signed the Record of Decision approving Ioneer’s plan of operations. That federal action cleared the proposed mine to proceed under its approved plan; it did not mean construction or lithium production had begun.
Why an approved mine is still waiting
Federal permission resolves a central regulatory risk, but it does not supply all the capital required to build a mine and processing complex. Ioneer’s board must still decide whether the financing, engineering, contracts and expected returns justify committing the company to construction.
The July 8 filing published through the SEC states that Ioneer has invested more than $220 million since 2016, completed more than 70% of advanced engineering, closed a $996 million federal loan and expects 275 to 300 permanent positions once the project operates; the same filing characterizes the memorandums with Korea Overseas Infrastructure & Urban Development Corporation and Hyundai Engineering as non-binding and warns that binding arrangements may never be completed. KIND is considering an equity investment, while Hyundai Engineering is evaluating procurement-related work, so neither agreement by itself supplies a committed construction package.
This distinction limits how the project can accurately be described. “Construction-ready” is the developer’s assessment of technical and permitting preparation, whereas full construction requires committed capital, binding contracts and board authorization. Rhyolite Ridge has moved well beyond an early exploration prospect, but it has not crossed that commercial threshold.
The federal loan is significant support, yet debt does not eliminate the need for equity or make every condition to funding disappear. The project must also retain enough financial flexibility to absorb construction costs, commissioning delays and the slower initial output that often accompanies the start-up of a new processing facility.
What the electric-vehicle figure really means
The mine’s scale is substantial even after separating potential capacity from actual output. A March 2026 account of the project and court ruling places its estimated cost at $2 billion, gives a projected life exceeding 77 years and attributes to Ioneer potential annual lithium-carbonate output equivalent to batteries for about 400,000 electric vehicles, while noting that the company was seeking a financial partner and targeting production in 2029. These are modeled project assumptions, not a guarantee that a corresponding number of vehicles will be produced or sold.
Multiplying the annual vehicle-equivalent estimate by the modeled mine life yields more than 30 million vehicle-equivalents. That arithmetic explains why the deposit can reasonably be discussed in terms of lithium for millions of electric cars, but it compresses decades of uncertain future operations into one eye-catching number.
Actual battery supply would depend on annual mine output, recovery rates, product specifications and operating uptime. Vehicle battery sizes and the amount of lithium required per pack also vary, so a vehicle-equivalent estimate is best understood as a scale comparison rather than a production contract with the automotive industry.
The timetable has already changed from the expectation attached to the original approval story. A later production target does not reduce the size of the resource, but it does postpone any contribution to domestic battery supply and adds another reminder that permitted capacity is not present-day supply.
The court ruling strengthened the permit, not the business case
A federal district judge rejected the conservation groups’ attempt to overturn the approval, removing a major immediate legal threat. The dispute centered on Tiehm’s buckwheat, an endangered wildflower whose entire known population occupies a small area within the project landscape; the court accepted mitigation that includes fencing and buffers, although the mine is expected to disturb part of the plant’s designated critical habitat.
That ruling strengthens the legal foundation for development, but it does not finance the mine or establish that its environmental measures will perform as intended over decades. The permit reflects a government determination that the approved plan satisfies federal requirements, not a conclusion that mining beside such a narrowly distributed species carries no ecological cost.
The environmental conflict is unusually site-specific. Protecting an equivalent area somewhere else cannot substitute for habitat when a species is known only from the immediate landscape, so compliance will depend on the effectiveness of boundaries, monitoring and adaptive measures around the actual population.
Large potential, unresolved execution risk
Rhyolite Ridge could become a meaningful domestic source of both lithium and boron, with processing planned at the Nevada site rather than only extracting material for treatment elsewhere. That combination gives the project industrial importance beyond the headline comparison with electric-car batteries.
Its next decisive milestone would be a final investment decision supported by binding financing and construction arrangements. Non-binding memorandums can advance negotiations, but they do not establish that the remaining capital is secured, procurement obligations are enforceable or a full building program can begin.
Even after that decision, construction, commissioning and ramp-up would separate the project from commercial deliveries. The current production target should therefore be treated as a developer schedule that remains exposed to financing, equipment, engineering, legal and site-execution risks.
The accurate status is narrower than the original “approved mine” headline implied: Rhyolite Ridge is a permitted and federally supported development project with very large modeled output. Its lithium may eventually support millions of vehicles over the mine’s life, but none of the project’s regulatory, legal or partnership milestones means that material is entering electric-car batteries today.
